Run a renovation project

Track your budget and manage change orders

Set a renovation project's budget, log payments against it, and create, submit, and approve change orders when scope or cost changes.

Every renovation project has its own Budget and Change Orders tabs. The Budget tab is where you set what you expect to spend and log what you’ve actually paid. The Change Orders tab is where you document a change to that plan, mid-project, and route it for approval before it becomes part of the budget. This walks through both.

You’ll need a renovation project already set up before either tab has anything to work with.

Open a project’s Budget and Change Orders tabs

Section titled “Open a project’s Budget and Change Orders tabs”

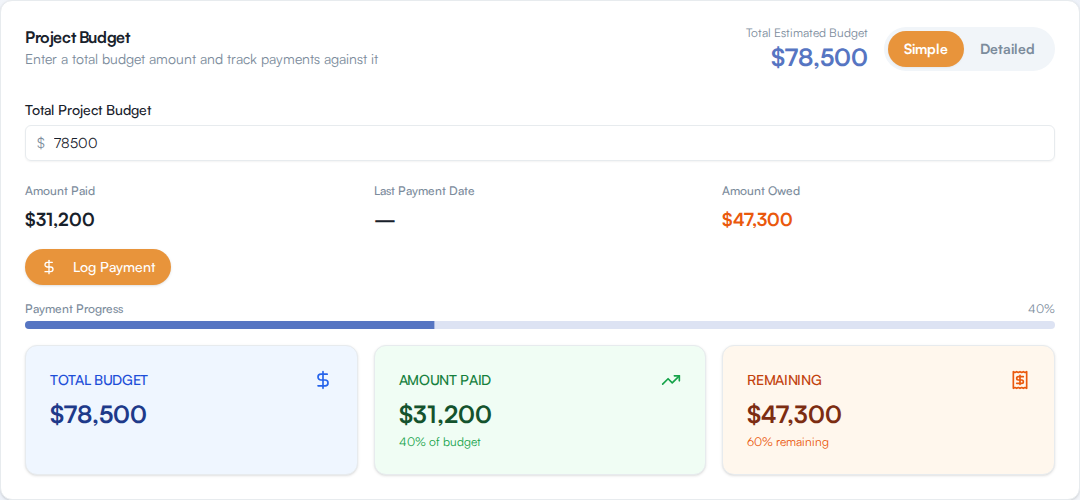

The Project Budget card in Simple mode, showing total budget, amount paid, amount owed, and the Log Payment button

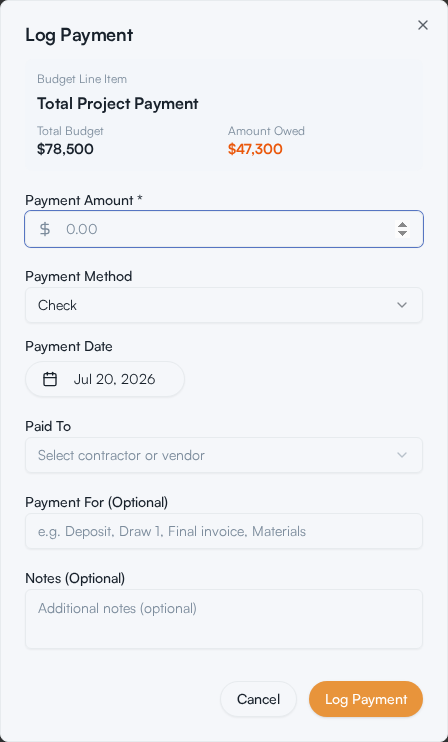

The Log Payment dialog, for recording a payment against the budget
  1. Open the renovation project from your Projects list.
  2. Along the top, you’ll see Overview, Team, Timeline, Budget, Change Orders, and Documents tabs.

The Budget tab has two modes, switched with a pill control in the top right: Simple and Detailed. A new project starts in Detailed mode. Switching modes doesn’t delete anything you’ve entered in the other one.

Use Simple mode if you just want one number to track against.

  1. On the Budget tab, switch to Simple.
  2. Enter a dollar amount in Total Project Budget.

That figure becomes your Total Estimated Budget, shown at the top of the tab and in three summary cards: Total Budget, Amount Paid, and Remaining, along with a payment progress bar.

To record money you’ve actually spent:

  1. Click Log Payment. This is disabled until you’ve set a total budget above zero.
  2. Enter the Amount, the date paid, a payment method (Check, ACH/Bank Transfer, Credit Card, Cash, or Other), who it was paid to, and what it was for.
  3. Save the payment.

Use Detailed mode to break the budget into phases and line items instead of one lump sum.

  1. On the Budget tab, switch to Detailed.
  2. If you haven’t added any phases yet, click Add Suggested Phases for a standard renovation sequence (Planning & Permits, Demo & Foundation, Framing & Rough-Ins, Drywall & Paint, Finishes, Closeout), or Add Phase Manually to name your own.
  3. Inside a phase, click Add Line Item to [phase]. Give it a Category/Description (for example, “Kitchen cabinets”), optionally assign a contractor, and enter Labor and Materials costs. The line item’s Total adds the two automatically.
  4. To log money paid against a specific line item, click Log Payment on that item and fill in the same fields as in Simple mode.

Line items don’t have to belong to a phase. Use the Unassigned Items section at the bottom for anything you haven’t sorted yet.

At the top of the tab, three cards track Estimated Budget (the sum of every line item’s Total), Amount Paid, and Remaining, with the percentage of budget spent shown under each.

A change order documents a change to the project after work has started: an unexpected repair, a material swap, added scope, a code requirement, and so on. Instead of quietly editing a budget line item, a change order records what changed, why, its cost, and any effect on the schedule, and puts it through approval before it counts. Each one keeps its own audit trail of who created it, who acted on it, and when.

Change orders are available on both the Silver and Gold plans.

  1. Open a project and go to its Change Orders tab.
  2. Click Create Change Order (or Create First Change Order if this is the project’s first one).
  3. Fill in the Change Order Title and a Description of at least 10 characters.
  4. Optionally choose a Category (Unforeseen Conditions, Design Change, Scope Addition, Material Upgrade/Downgrade, Code/Permit Requirement, Weather/External Delay, Contractor Error/Correction, or Other) and a Related Project Phase, if the project has phases set up on its Timeline tab.
  5. Under Financial Impact, enter the Requested Amount. A preview shows your project’s current budget, what’s been spent, this change order’s amount, and the resulting adjusted budget.
  6. Under Timeline Impact, choose No Impact, Minor (1-3 days), Moderate (4-7 days), or Significant (8+ days). Choosing anything but No Impact adds a Days Added to Schedule field.
  7. Under Contractor/Vendor Information, assign an existing project contractor, or choose Other/New Vendor and enter their company, contact, phone, and email. This is required.
  8. Optionally add a Quote/Bid Reference Number, attach supporting documents, and add Internal Notes for anyone reviewing the request.
  9. Click Submit for Approval.
A pending change order listed with its number, title, amount, and Approve action

Approving or rejecting a change order is an Admin capability. Creating one and submitting it for approval is something an Admin or a Power User can both do. See Roles explained for the full breakdown of what each role can do. This is enforced by the app, not just by what is shown on screen: a Power User or User cannot approve or reject a change order, or change the amount or schedule of one that is already approved.

That submit/approve split only means something once more than one person is in your organization, which is a Gold-plan capability. On Silver, your organization is a single user, and that person is the Admin, so the same person who creates a change order is also the one who approves it. Nothing about the flow below requires a second person; it’s just how the roles are set up once you add one.

To act on a pending change order:

  1. On the Change Orders tab, open the change order (click its row, or use the View option from its Actions menu).
  2. To approve it, click Approve Change Order. A confirmation shows the budget amount about to be added and, if the change order carries a timeline impact, how many days it will add to your schedule. Confirm to apply it.
  3. To reject it, click Reject, enter a reason of at least 10 characters, and confirm.

How an approved change order affects your budget

Section titled “How an approved change order affects your budget”

Approving a change order adds its amount to the project’s total budget automatically, in both Simple and Detailed mode. You don’t edit your budget or add a line item for it.

Your own figure stays as you entered it. Once a project has an approved change order, the top of the Budget tab labels your figure Base Budget, shows the approved amount on its own line (“+ $6,500 approved change orders”), and shows the Total Budget underneath. The total is what the rest of Re:InvestorHub uses, including the project’s budget card and Remaining. See How your project budget is calculated.

If the change order carried a timeline impact with days added, approving it also pushes your project’s target completion date back by that many days (as long as the project already has one set).

Every change order keeps an audit log of what happened to it: when it was created, each status change, edits, and any files attached or removed, each with who did it and when. Open a change order and scroll to its Audit Log to see the full history. Files attached to a change order are listed under Attached Files, where you can view or download them.

To edit or delete a change order, use its Actions menu on the Change Orders tab. Deleting a change order can’t be undone.
